Slope hydroseeding, Bonded Fiber Matrix (BFM) for steep grades, detention basin banks, and roadway shoulders. Engineered for the steep grades and red-clay soils that define tough Carolina Piedmont sites — where dry seed and straw simply wash away.
Steep grades are where most seeding jobs come apart. Dry seed and straw slide off with the first heavy rain. Our erosion-control work is built specifically for these sites.

For the steepest grades we apply Bonded Fiber Matrix (BFM) — a slurry that cures into a continuous bonded blanket, holding soil and seed in place while roots establish. On moderate slopes, the tackifier binder in every mix bonds the slurry to the soil surface so it stays put on grades that would shed loose seed.

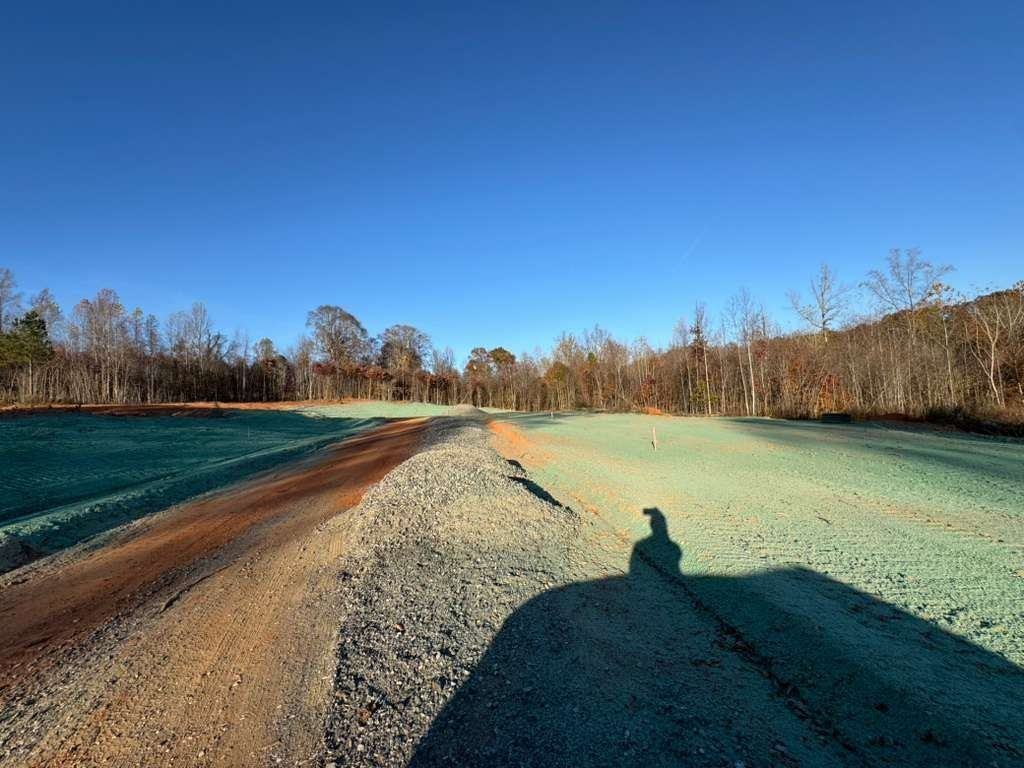

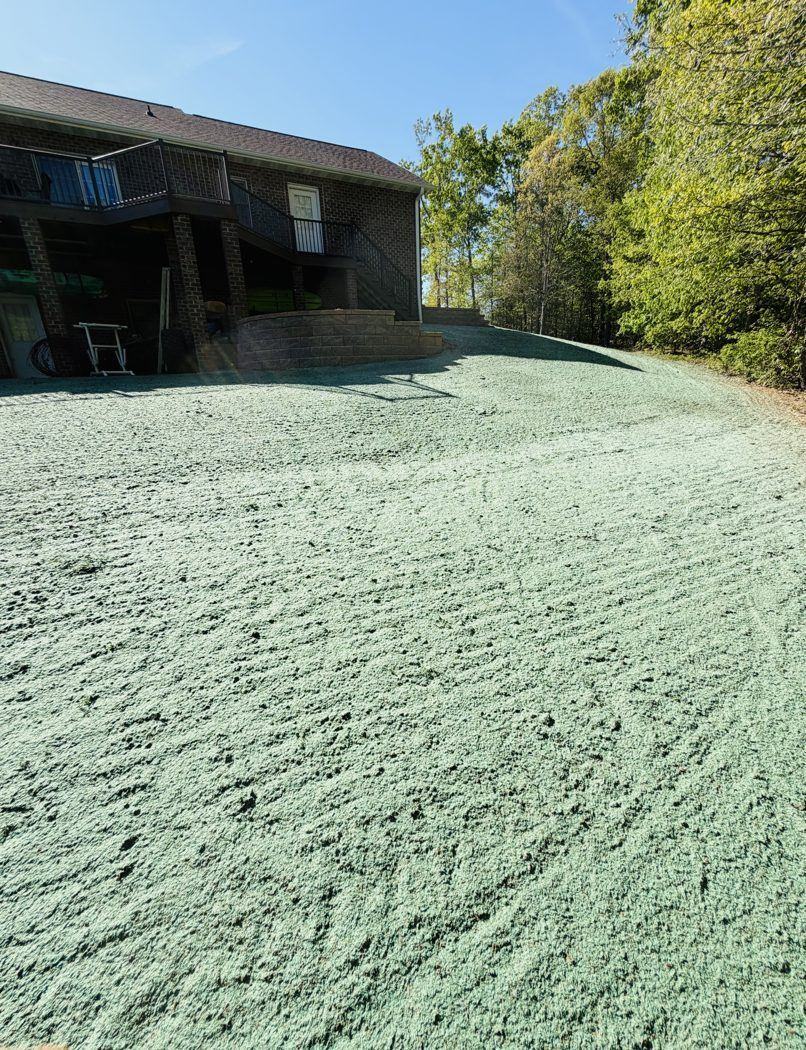

We handle slope hydroseeding, detention and retention basin banks, roadway and driveway shoulders, large-acreage embankments, and riprap-edge and drainage-channel cover. If it's steep, raw, and has to hold through the next storm, it's exactly what we're built for.
Not every slope needs the same product, and matching the method to the grade, soil, and flow condition is where erosion control is won or lost. Here is how the four common approaches compare — and where each one belongs on a Carolina Piedmont site.
| Method | Best Slope Range | Functional Longevity | Typical Application |
|---|---|---|---|
| Standard Hydroseed Seed · wood-fiber mulch · tackifier · fertilizer |
Flatter than 4:1 (H:V) | Establishes cover; mulch degrades ~3–6 mo | Lawns, pads, gentle graded areas, large flat acreage |
| Tackified / Stabilized Mulch Matrix (SMM) Higher tackifier load, heavier mulch |
4:1 to 3:1 | Up to ~3 months of protection | Moderate slopes, roadway shoulders, basin approaches |
| Bonded Fiber Matrix (BFM) Thermally/chemically bonded continuous blanket |
3:1 to 2:1 (and steeper with anchoring) | Up to ~6 months; cures into a bonded layer | Steep cut/fill slopes, detention banks, high-runoff grades |
| Dry Seed & Straw Broadcast seed + loose straw |
Flat only | Washes off in the first heavy rain on any grade | Not recommended on slopes — a common cause of failure |
Slope ratios are written horizontal:vertical — a 3:1 slope drops 1 foot for every 3 feet of run (~18°); a 2:1 slope drops 1 foot for every 2 feet (~27°). Steeper than 2:1 typically calls for BFM plus supplemental measures such as blankets, matting, or terracing.

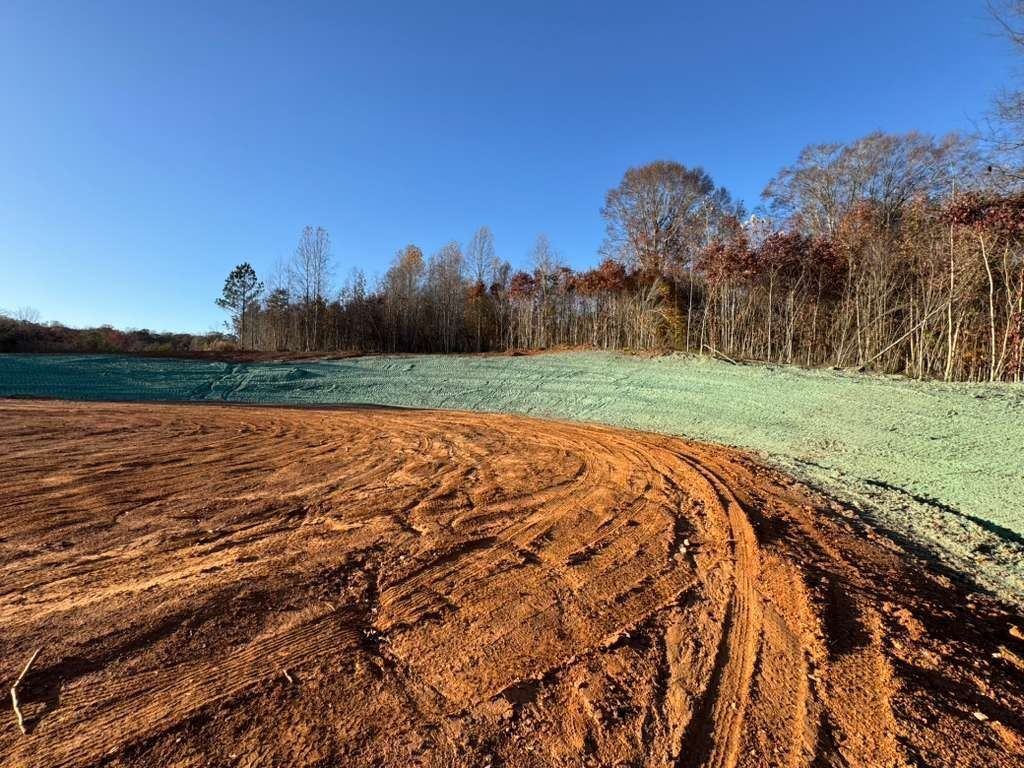

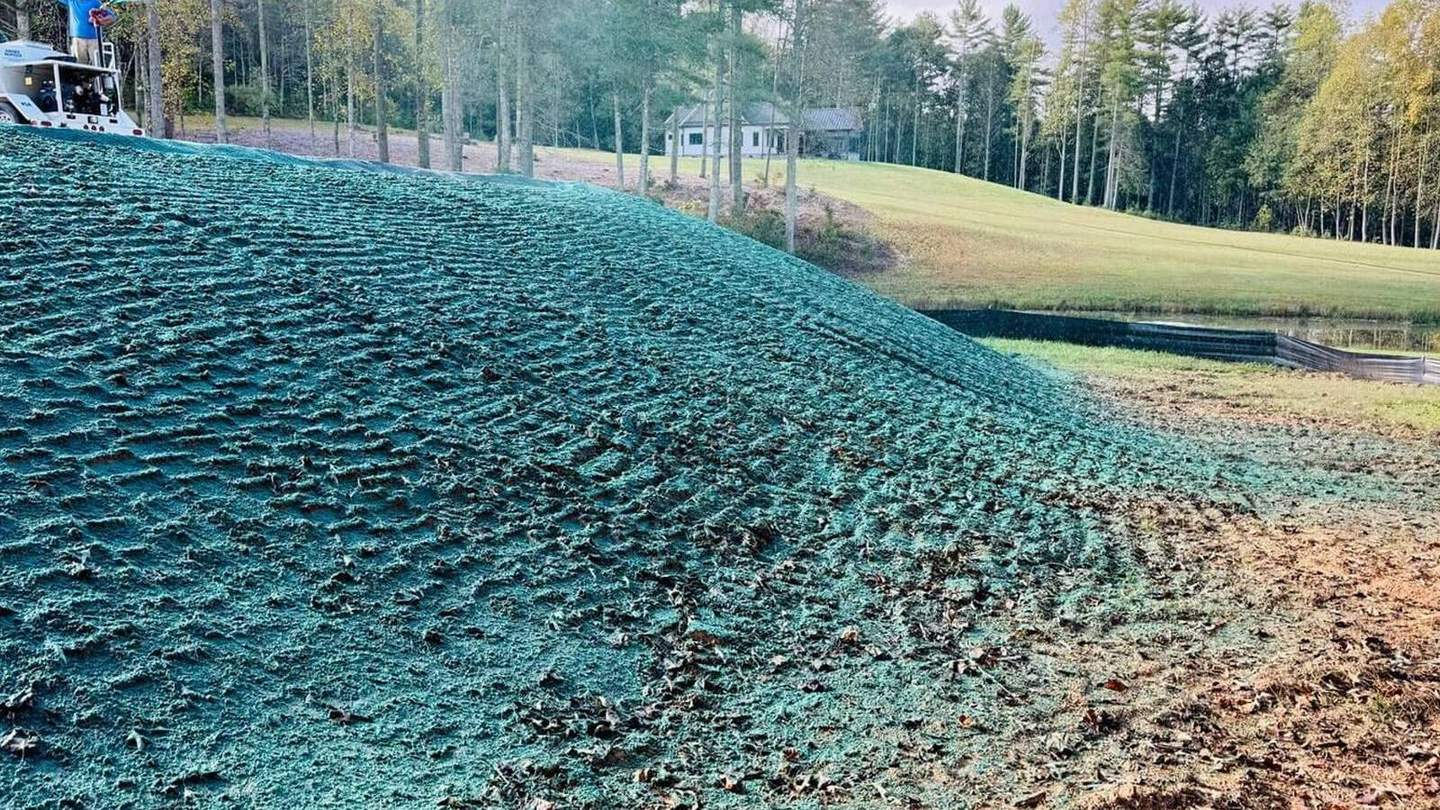

Bonded Fiber Matrix is a hydraulically-applied slurry of long-strand wood or blended fibers combined with cross-linked bonding agents. Unlike standard mulch that sits loose on the surface, BFM cures into a single continuous, porous blanket that adheres to the soil and to itself — with no gaps for concentrated flow to exploit.
That bonded layer holds seed and soil in place through the critical germination window, absorbs rainfall impact instead of letting it detach soil particles, and stays permeable so water infiltrates rather than sheeting off. It typically reaches full cure in 24–48 hours of dry weather, so we watch the forecast and time application to give it a curing window before the next rain event.

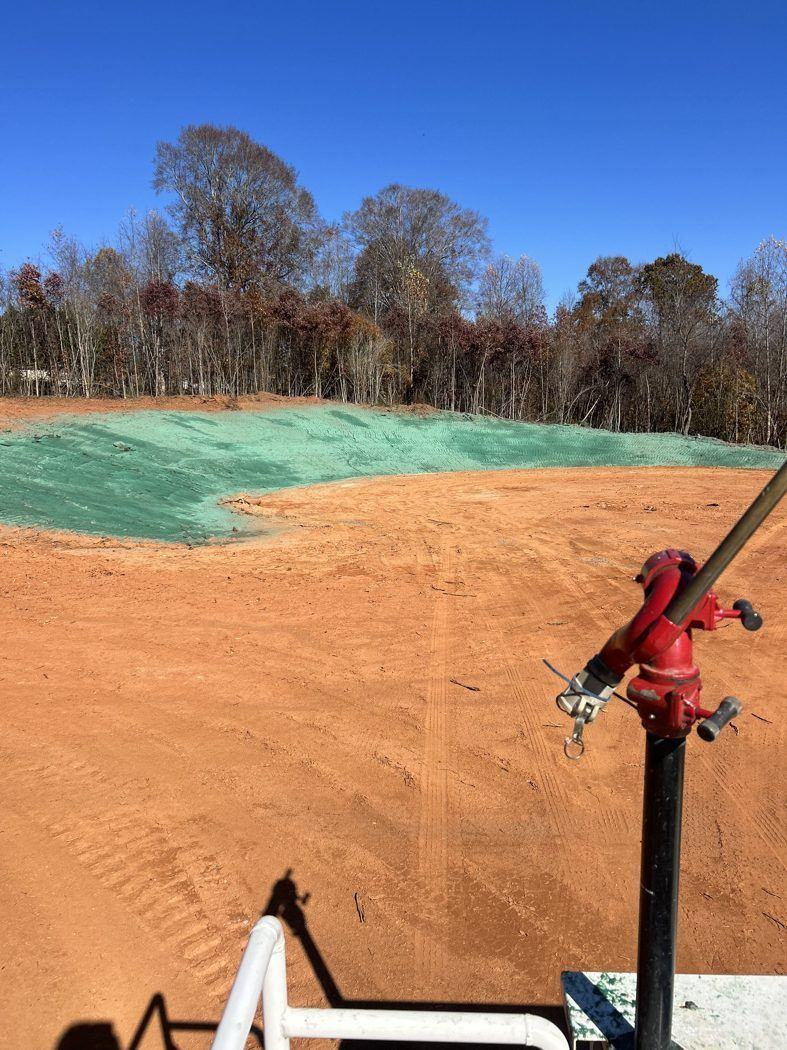

The right call depends on more than steepness. We evaluate the grade ratio, the soil's erodibility (Piedmont red clay behaves very differently from sandy fill), the length of the slope, whether flow concentrates or stays as sheet flow, and how soon the site will see rain.
When we walk your site, we tell you which product the slope actually needs — not the one that's easiest to sell. Over-spec'ing wastes your money; under-spec'ing fails inspection and washes out.
In North Carolina, land-disturbing activity of one acre or more is regulated under the NPDES Construction General Permit (NCG010000) and the state Sedimentation Pollution Control Act, administered by NCDEQ's Division of Energy, Mineral & Land Resources. Ground stabilization is not optional — it's a permit condition with hard deadlines, and hydroseeding is one of the primary ways sites meet it.
North Carolina's ground-stabilization timeframes require temporary or permanent cover within 7 calendar days for perimeter dikes, swales, ditches, slopes, and High Quality Water zones, and within 14 days for most other disturbed areas. We schedule around those clocks.
Permit close-out requires uniform, established ground cover — typically 70%+ vegetative density — across all disturbed areas before the Notice of Termination is accepted. We seed to hit that density, not just to green up for a photo.
We work directly with your site superintendent, erosion-control inspector, and the local jurisdiction so the seed application lands on the right day in the SWPPP sequence and holds up at the stabilization inspection.
Requirements vary by permit, jurisdiction, and site conditions. TerraSeed provides the seeding and stabilization work; the design engineer and permit holder remain responsible for the erosion & sediment control plan. We coordinate to the plan and the inspector's direction.
A bonded slurry holds the slope through germination — instead of washing into the drainage line.

Tackifier and BFM bond the slurry to the grade so it stays put while roots take hold.
We walk the site, evaluate grade, soil, and runoff, and recommend straight hydroseeding, tackified mix, or full BFM.
We build the right slurry for the grade — premium seed, mulch, tackifier, and BFM where the slope demands it.
Our hydroseeders apply a continuous, bonded layer that holds soil and seed in place against rain and runoff.
We follow up to confirm the slope took and the cover is holding through the establishment window.
Straight answers on methods, slope ratios, BFM, and NC compliance. If your question isn't here, call (828) 244-7496.
BFM is a hydraulically-applied slurry of long-strand fibers and cross-linked bonding agents that cures into a single continuous, porous blanket bonded to the soil surface. Unlike loose mulch, it leaves no gaps for concentrated flow, absorbs rainfall impact, and holds seed and soil in place through germination — which is why it outperforms straw and standard mixes on steep grades.
Standard hydroseed works on grades flatter than about 4:1. From 4:1 to 3:1 we go to a tackified mulch matrix; 3:1 to 2:1 calls for BFM. Steeper than 2:1 (roughly 27°) usually needs BFM combined with erosion-control blankets, matting, or terracing. We assess the exact grade, soil, and flow on-site before specifying.
It comes down to grade, soil erodibility, slope length, and runoff. Moderate slopes with sheet flow are usually fine with a tackified mix. Steep cut/fill slopes, detention basin banks, channel sides, and any grade facing an imminent rain event are where BFM earns its cost. Piedmont red clay's erodibility often pushes borderline slopes toward BFM.

Yes. Basin banks, spillway approaches, embankments, and drainage features are among the most common erosion-control jobs we do — both the vegetative cover and the bonded matrix that keeps it from washing out before it establishes.
In NC, sites disturbing one acre or more fall under the NPDES Construction General Permit and the Sedimentation Pollution Control Act (administered by NCDEQ). Ground stabilization is required within 7 days on slopes, perimeters, and HQW zones and 14 days elsewhere, with final stabilization typically needing 70%+ vegetative cover for permit close-out. We schedule and seed to hit those deadlines and densities.
On any real grade, loose seed and straw slide downhill with the first heavy rain, leaving bare, eroding soil and a failed inspection. Hydroseeding with tackifier or BFM bonds seed, mulch, and amendment to the slope surface in one pass so it stays where it's sprayed.
Yes — roadway shoulders, driveway embankments, and the cut-and-fill slopes that come with them are routine erosion-control work for us across the Piedmont, including the concentrated-flow areas where standard mulch won't hold.
